Connect Paul R. Lowry Road to Shelby Drive with improvements ending at Weaver
Please click the links below to view the three alternate options for the GO Project.

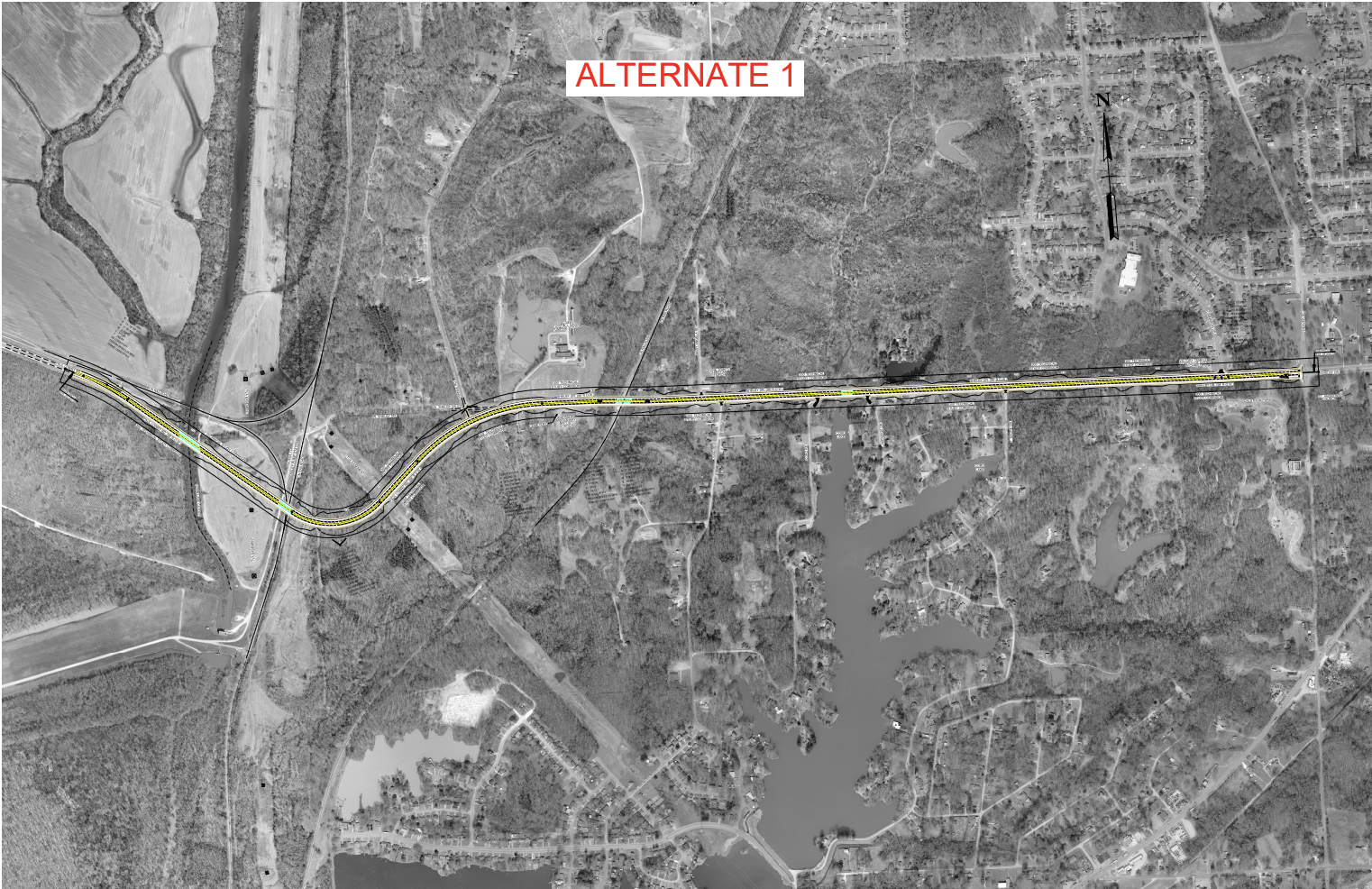

Alternate 1

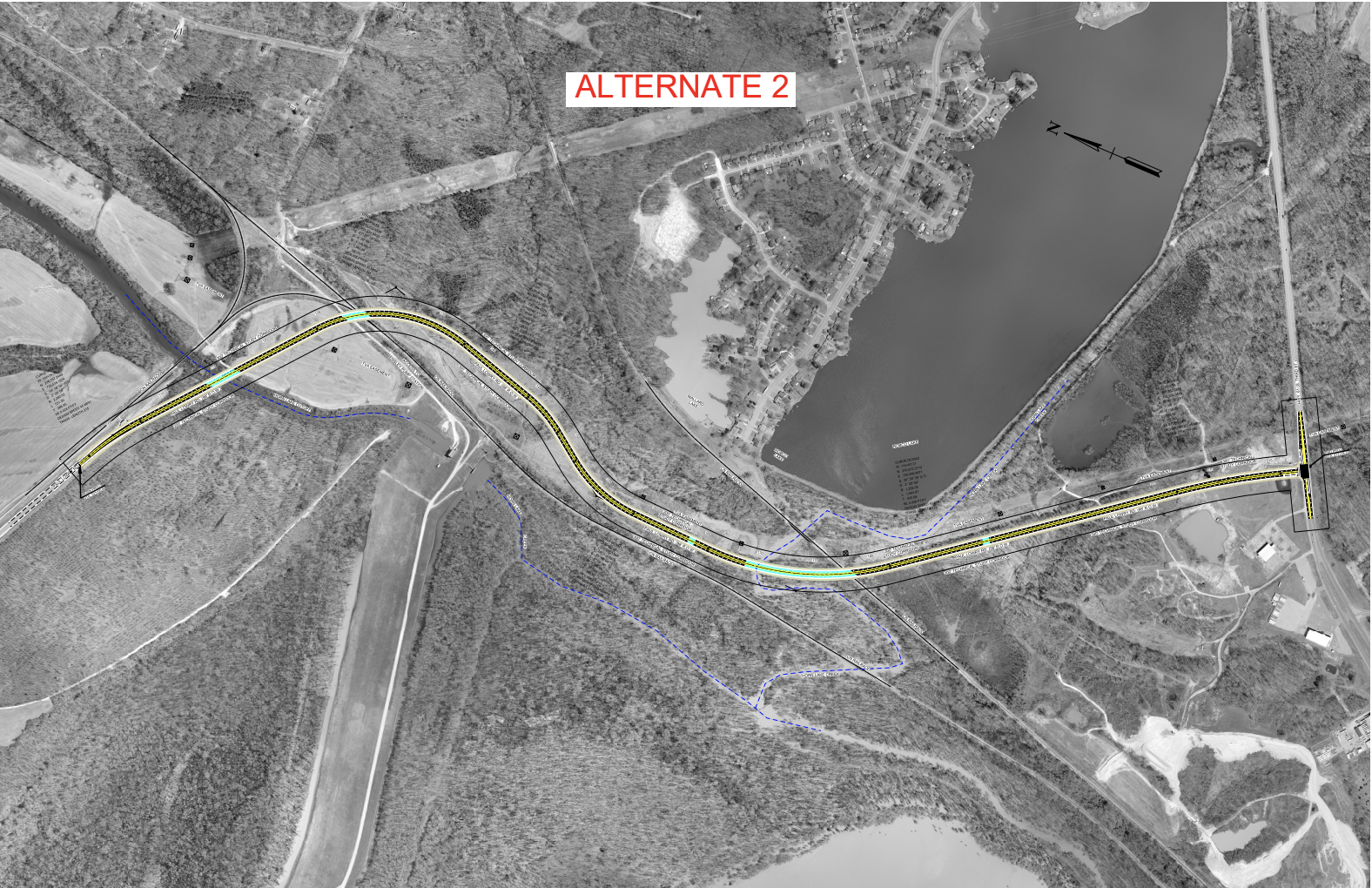

Alternate 2

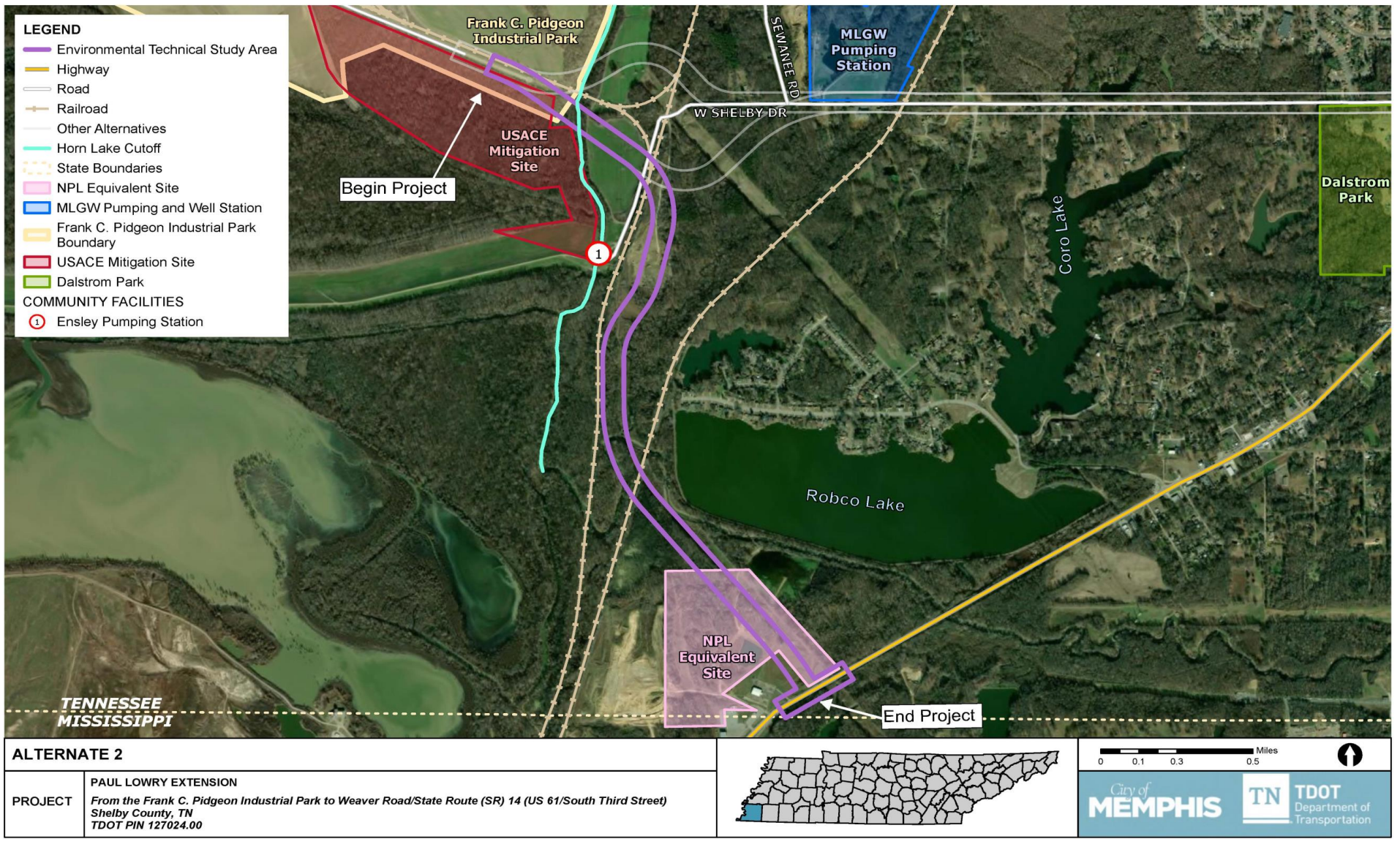

Connect Paul R. Lowry Road to U.S. 61 (Third Street) through a new road South of Robco Lake
Alternate 3
Do Nothing
What’s Possible for Your Community
This is what your community could look like including access to jobs, educational opportunities, walkability, beautification, and more.
Frequently Asked Questions
What is this project?
The City of Memphis, in coordination with the Tennessee Department of Transportation (TDOT), and the Federal Highway Administration (FHWA), is proposing to extend Paul R. Lowry Road from its current terminus at the south end of the Port of Memphis’ Frank C. Pidgeon Industrial Park to Weaver Road or State Route (SR) 14 (US-61/South Third Street) in Shelby County, Tennessee.
The proposed project is sponsored by the Economic Development Growth Engine for Memphis and Shelby County (EDGE) and the International Port of Memphis.
Paul R. Lowry Road, in the project area, is currently a two-lane facility (one travel lane in each direction) with 11-foot travel lanes and two-foot shoulders that terminates in the southeastern section of the Frank C. Pidgeon Industrial Park, just west of the Horn Lake Cutoff.
What are the potential options for this project?
The field technicians will help determine the feasibility of roadway and neighborhood enhancements in Southwest Memphis. They are researching three potential options.
- Connect Paul R. Lowry Rd. to Shelby Drive with improvements ending at Weaver. Improvements would include neighborhood enhancements such as sidewalks, decreased blight, and increased lighting.
- Connect Paul R. Lowry Rd. to U.S. 61 (Third St.) through a new road South of Robco Lake, including neighborhood enhancements.
- Do nothing.
When did this project begin?

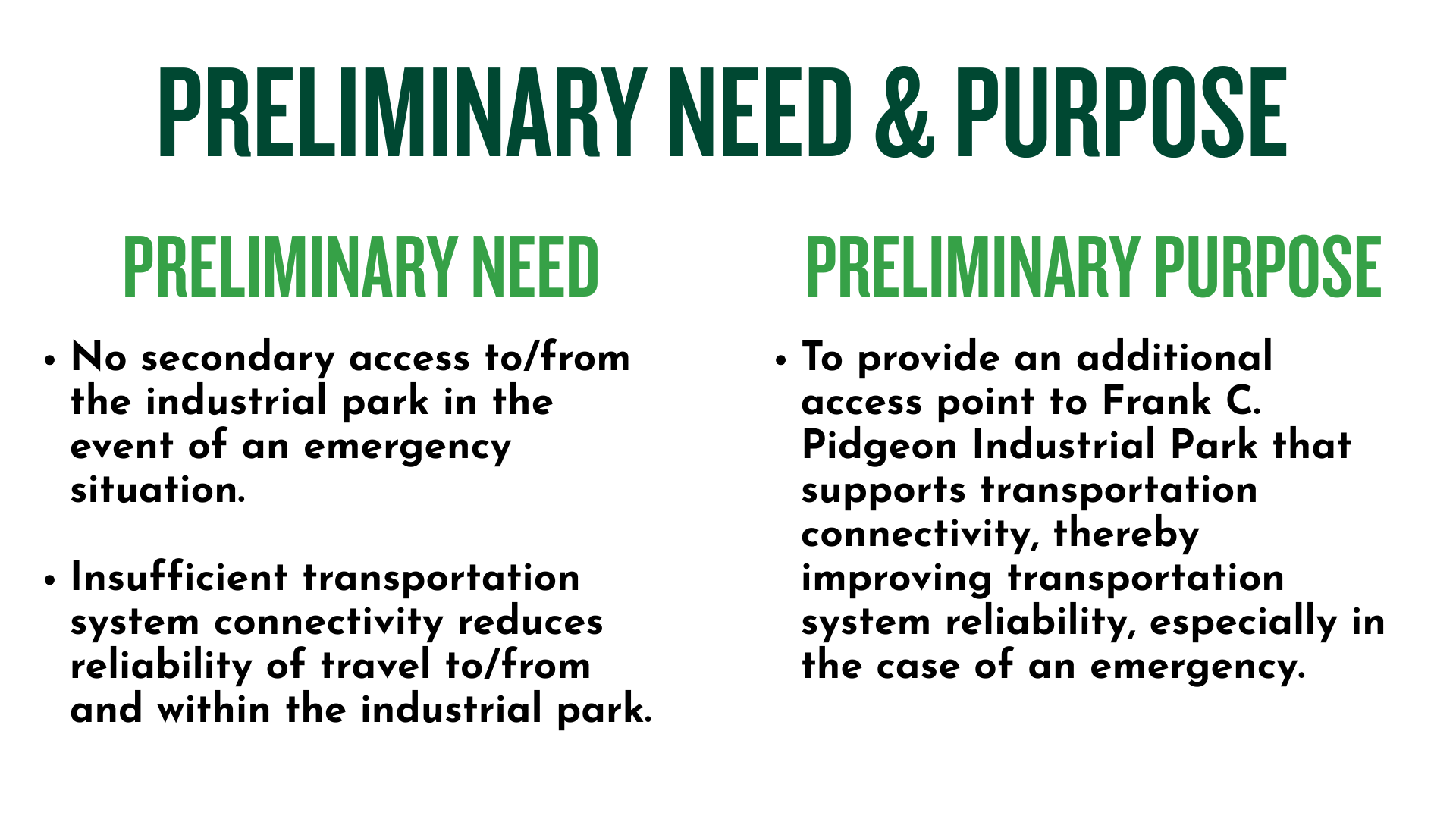

The need for additional access to Frank C. Pidgeon Industrial Park was identified in 2016 by EDGE, the International Port of Memphis, the Industrial Development Board, and the City of Memphis.
To analyze existing project data and begin establishment of the purpose and need of the proposed project, a Transportation Investment Report (TIR) was developed and examined three improvement options.
What is the size of the area being considered for this project?
The proposed project ranges from approximately 2.2 miles to 2.7 miles in length, depending on the alternative.
Where is the proposed location for the road extension?
The proposed location of the Paul R. Lowry Road extension lies north of the Tennessee and Mississippi border in Shelby County, Tennessee. The proposed project is south of Shelby Drive and West of Weaver Road. Portions of the Westwood, Westwood Shores, and Coro Lake communities in South Memphis are within the project area. The proposed project is within the City of Memphis Westwood Planning District.
West of Horn Lake Cutoff, near the current terminus of Paul R. Lowry Road, land uses include industrial, agricultural, woodland, railroad, and utilities. East of Horn Lake Cutoff, land use is primarily single family residential with some park and open space use along Shelby Drive. The Memphis Light, Gas, and Water (MLGW) Justin J. Davis Pumping Station and Water Treatment facility is located on the north side of Shelby Drive just west of the CN railroad. Dalstrom Park is located within the southeast corner of the Shelby Drive and Weaver Road intersection. Several lakes and a number of wetlands are also located in the project area. A U.S. Army Corps of Engineers (USACE) mitigation site is located adjacent to the southeastern boundary of the Frank C. Pidgeon Industrial Park and a National Priorities List (NPL) equivalent site is located west of SR-14 (US-61/South Third Street) near the terminus of Build Alternative 2. The NPL equivalent site is currently being remediated.
Multimodal freight facilities exist within, and immediately adjacent to the industrial park. They include the Frank C. Pidgeon Port and Harbor, the CN and CSX Memphis railyard, CN intermodal facility, and the port facilities operated by the USACE at Ensley Yard. Roadway access to the industrial park is currently only available through Riverport Road in the northeastern corner of the park.
Paul R. Lowry Road is classified as an urban minor arterial roadway and currently ends in a cul-de-sac in the southeast corner of the Frank C. Pidgeon Industrial Park. Shelby Drive in the project area is currently an unimproved two-lane facility (one travel lane in each direction) with 11-foot travel lanes and 0-to 2-foot shoulders. It is a residential street with homes on both sides of the road. SR-14 (US-61/South Third Street) is classified as an urban other principal arterial1. SR-14 (US-61/South Third Street transitions from a four-lane divided roadway to a four-lane roadway just north of the Mississippi/Tennessee state line.
Will I have a voice in whether they move forward with these potential projects?
Yes. The project has been studied and reviewed by experts and discussed with residents. Resident engagement has happened through surveys, community meetings, hearings, and more. Further, residents can remain updated on the project progress on this website.
Will I lose all or part of my property if construction happens?
It’s too early to tell if any properties will be directly affected if a construction project is approved. Also, it would take several years before construction begins.
Who would make the final decision on which alternate would be selected?
The decision would be based on the following criteria not necessarily listed in order or priority:
The design team will consider all the information obtained from environmental studies (including air and noise quality studies), costs, potential economic benefits for the community, public meetings, and community involvement to recommend the best and most effective alternate. It would then be submitted to the Mayor for approval. If approved it would be submitted to TDOT/State for concurrence.
Project Timeline
Federal Requirements
Title 23 of the U.S. Code (USC) 139(g) requires the lead agencies associated with the development of an Environmental Impact Statement (EIS), with optional use for an Environmental Assessment (EA), to establish a plan for coordinating public and agency participation and comment during the environmental review process. While the City of Memphis has chosen to not follow the entire 23 USC 139 process for this EA, the City of Memphis has opted to prepare a coordination plan and schedule and designate Cooperating and Participating Agencies from that optional process, as part of its standard practice for projects for which an EA is prepared.
For more information: https://codes.findlaw.com/us/title-23-highways/23-usc-sect-139/
State Requirements
TDOT must meet the requirements of its Public Involvement Plan: Statewide Transportation Public Participation Guide. The Paul R. Lowry Road Extension project is classified as a TDOT Level 3 project. The Level 3 classification encompasses projects that require completion of an Environmental Assessment (EA). A Level 3 classification requires the development of a project-specific Public Involvement Plan (PIP) that outlines specific activities to be carried out during the planning process. Since the federal Coordination Plan and the PIP contain similar information, TDOT has combined the two documents into this single document (ACPIP) that meets the requirements for both.
For more information: tn.gov/content/dam/tn/tdot/document
Preliminary Project Schedule
Forecasted dates are subject to change.
- Conduct Technical Studies – Through Quarter 3, 2026
- National Environmental Policy Act (NEPA) Public Meeting – Quarter 3, 2026
- Environmental Assessment Approval / Notice of Availability – Quarter 4, 2026
- NEPA Public Hearing – Quarter 1, 2027
- Approval of Final Environmental Document / Selection of Selected Alternative – Quarter 3, 2027
- Once the final environmental document is approved by the Federal Highway Administration, the Planning and Environmental Phase is complete.
- Right-of-Way Acquision Phase – TBD
- Construction Phase – TBD
